Many risks are not in the quote but in the small print of the contract. Three points are always worth a close look.
1. Acceptance (Abnahme)
With acceptance, the risk passes to the client (§ 12 Abs. 6 VOB/B), and the period for defect claims begins. If the VOB/B has been agreed and no acceptance is requested, the work is deemed accepted: 12 working days after written notification of completion (§ 12 Abs. 5 Nr. 1 VOB/B), and in case of use, 6 working days after the start of use (§ 12 Abs. 5 Nr. 2 VOB/B).
If a contract excludes deemed acceptance and requires an express written acceptance, a completed work can remain “in limbo” for a long time – for example if the client stays silent.
2. Warranty (Gewährleistung)
Defect claims for a building become time-barred under the BGB after five years (§ 634a Abs. 1 Nr. 2 BGB), and under the VOB/B as a rule after four years (§ 13 Abs. 4 VOB/B). Deviating periods in the contract – for example six instead of four years – should be agreed deliberately and factored into your calculation.
3. Retention (Sicherheitseinbehalt)
A security is meant to secure performance in accordance with the contract and the defect claims (§ 17 Abs. 1 VOB/B). Retention, deposit or guarantee are possible; under the VOB/B the contractor can choose among the types of security and can exchange them (§ 17 Abs. 3 VOB/B). Check the amount, the duration and the time of release.
How the review works in BauWalker
You choose the contract and, if you like, ask your own question, for example about acceptance and warranty.

The review takes up to about ten minutes; you can close the page. BauWalker compares the contract with the VOB/B and the BGB.

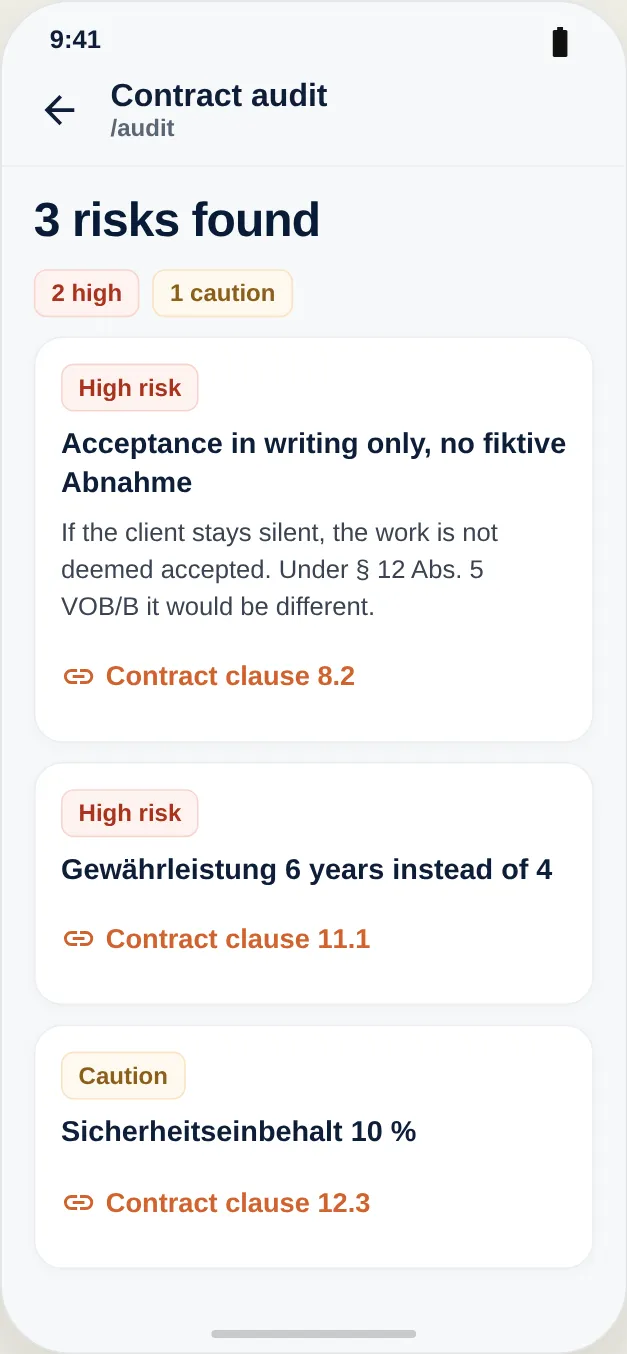

In the report you see the risks by severity, each with the contract clause it is based on.


Author, sources and status
Author: Boris Pushkarev · Last updated:
When to seek professional advice
For concrete disputes, running deadlines or larger amounts, consult a lawyer (Rechtsanwalt). This article is general information and does not replace legal or tax advice for your case.
Updates
If laws, standards or case law change, the article is adjusted. The date above shows the latest change.
How it works in BauWalker
The report is a working aid: it shows where you should look more closely – the decision stays with you.
This material is for information and is not legal or tax advice. The specific consequences depend on your contract and the circumstances on the construction site.
Keep reading
VOB/B explained simply
What the VOB/B is, when it applies and how it differs from an ordinary BGB contract.
How does a Nachtrag work in a construction contract?
When a Nachtrag arises, what belongs in the justification and how to avoid disputes.
German regulations
Questions on VOB/B, BGB and other regulations: the answer cites the source and separates what is verified from assumptions.
